Recognizing Active Construction Defects in the Field

July 8, 2026

Test Your Knowledge

12 questions - Audio-based - Study on the go

Audio Quiz

Questions are read aloud. Tap to start — works with your phone in your pocket.

Mapped to the General B study path

Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.

Related study paths
Source & Confidence

This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.

Official CSLB topicProject Management - mapped to the public CSLB B General Building study-guide areas.
California rule verifiedRule, code, permit, safety, minimum, and maximum claims are treated as California-source claims and should be backed by official/public California or CSLB-referenced sources.
Background explanationStories, examples, analogies, and memory aids help busy learners retain the source-backed concepts without sitting in a classroom.
Needs re-checkFor live job, legal, safety, permit, plan, specification, or manufacturer-instruction decisions, verify the current source and follow the AHJ.
Last reviewedJuly 8, 2026

This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.

In this episode, I cover active construction defects in the field: poor workmanship, unauthorized substitutions, out of tolerance framing cuts, pre cover inspection hold points, defect logs, California Residential Code Section R109.1, California Green Building Standards Code Section 4.505.3, California Plumbing Code Appendix C101, and California Business and Professions Code Sections 7068.1, 7109, and 5537. This matters because the published CSLB study outline places design and construction error identification inside Planning and Estimating, and a General Building contractor has to recognize a defect early enough to stop it from becoming a buried problem.

I want you to think of an active construction defect as a problem that is still alive. It has not been buried by drywall, hidden under flooring, painted over, or accepted as part of the finished work. It is still sitting in front of you during construction, waiting for the person in charge to decide whether the job keeps moving or stops long enough to correct it.

That is why this topic belongs in Planning and Estimating, not just law. A missed defect changes the plan, the schedule, the cost, the inspection path, and sometimes the repair authority. A bowed stud is not just a bowed stud when insulation is already scheduled. Wet framing is not just wet framing when drywall is on the truck. A substituted shear panel is not just a material choice when the approved plans call for a specific rated assembly.

I use 3 questions in the field. 1st, does the work match the approved plans and specifications. 2nd, does the work meet accepted trade standards and the applicable code limits. 3rd, if the answer is no, do I have authority to coordinate correction, or has the problem crossed into engineering territory. Those questions keep a contractor from guessing, and guessing is where good field judgment gets expensive.

A defect is not always dramatic. Sometimes it is a fastener pattern that slowly changed as the crew got tired. Sometimes it is a plumber boring a clean, pretty hole that is simply too large. Sometimes it is a substitution made with good intentions because the supplier was short. The work can look neat and still be wrong. That is one of the big exam prep ideas here: quality control is not the same thing as appearance control.

California contractor law puts the responsibility for direct supervision and control on the license qualifier. Business and Professions Code Section 7068.1 describes that control in practical terms. It includes checking jobs for proper workmanship and managing construction activities through technical and administrative decisions. That is a plain jobsite sentence hiding inside legal language.

I take that seriously because it means the city inspector is not my quality control department. The enforcing agency has an important role, but an inspector usually sees a limited sample of the project at a scheduled point in time. The contractor is the one who has to manage the work as it is actually being built, trade by trade, day by day.

That is where a defect log or rolling punch list earns its keep. I do not treat it as paperwork for paperwork's sake. I treat it like a black box recorder for the project. If something is wrong, I want the location, the trade, the date, the condition observed, the plan or code issue, the corrective action, who is responsible, and when it was verified. A defect that lives only in somebody's memory is too easy to lose when the schedule gets loud.

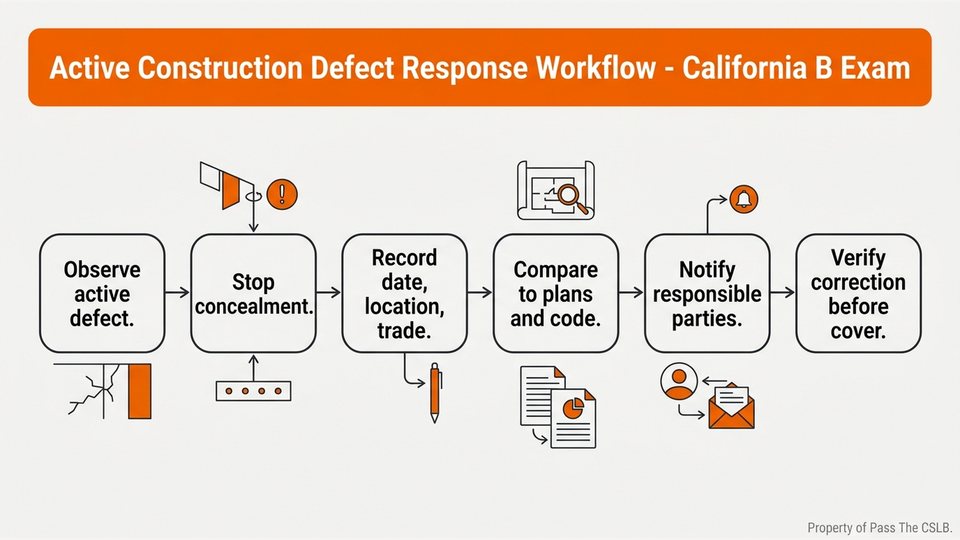

Active Construction Defect Response Workflow - California B Exam. Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.
Active Construction Defect Response Workflow - California B Exam - Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.

Looking at this workflow, I want you to notice the order. Identify the problem, stop the wrong next step, document the condition, compare it to the governing source, notify the right parties, and verify correction before cover. The order matters because a contractor who documents a defect but lets it get concealed has not really controlled it. Documentation is not a substitute for supervision. It is the evidence that supervision happened.

Here is my memory line: see it, stop it, log it, source it, fix it, verify it. Say that like a field rhythm. See it, stop it, log it, source it, fix it, verify it. That rhythm helps separate a professional response from a hallway conversation.

The pre cover inspection rule is the moment when this whole subject becomes very concrete. California Residential Code Section R109.1 says reinforcing steel or structural framework shall not be covered or concealed without first getting approval from the enforcing agency. The same idea applies to the timing of framing approval: roof deck, framing, fire blocking, and bracing need to be in place, and rough mechanical, electrical, and plumbing approvals come before framing is closed up.

I call this the X ray vision checkpoint. Before insulation and drywall, the building is temporarily honest. You can see the load path. You can see the holes in joists. You can see fire blocking. You can see missing shear nails. You can see pipes, ducts, wires, straps, plates, and framing connections. After cover, the same building starts telling secrets only through symptoms: a crack, a sag, a smell, a leak, a callback, or a lawsuit.

The practical rule is simple. Do not cover structural framework or reinforcing steel before the enforcing agency approval. Do not let a subcontractor outrun the inspection sequence because the schedule is tight. A photo on a phone is not the same thing as the required approval. A verbal guess that the inspector will be fine with it is not the same thing as approval. In exam prep terms, this is a hold point. In field terms, this is the last cheap moment to catch a hidden defect.

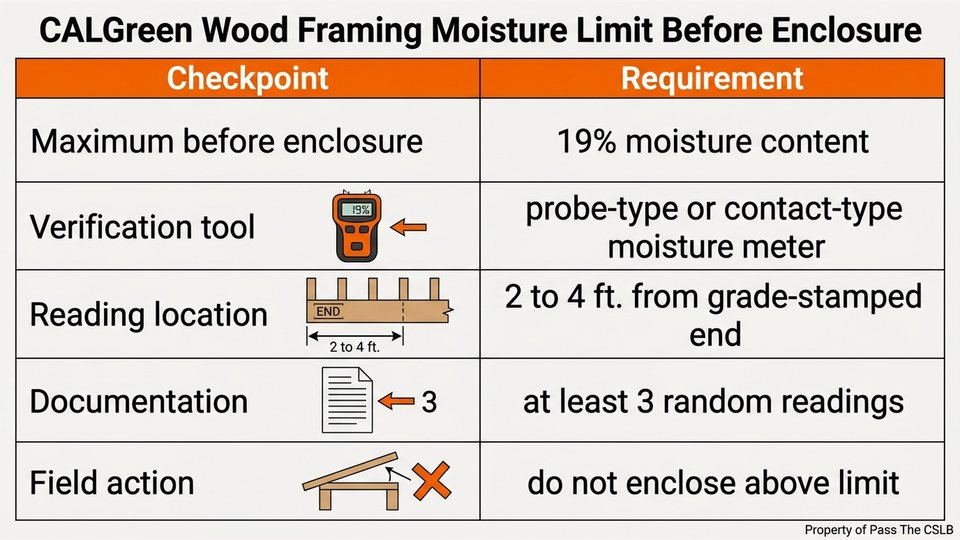

Moisture is the defect that looks harmless until the wall is sealed. California Green Building Standards Code Section 4.505.3 gives the number I want you to memorize: wall and floor framing must not be enclosed when the framing members exceed 19% moisture content. The code does not ask the contractor to slap the stud and guess. It calls for a moisture meter, probe type or contact type.

CALGreen Wood Framing Moisture Limit Before Enclosure. Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.
CALGreen Wood Framing Moisture Limit Before Enclosure - Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.

This chart is the moisture checkpoint. The key number is 19%. Above that, the wall is not ready to be enclosed. Materials showing visible water damage should not be installed. Moisture readings are taken with a meter, and the source material identifies readings 2 to 4 ft. from the grade stamped end, with at least 3 random readings documented for the enforcing agency before enclosure approval.

The why is building science, not bureaucracy. Wood above roughly the problem range for decay and fungal growth, trapped in a dark wall cavity with insulation and drywall, becomes a food source with poor drying potential. Even when the wood does not rot, wet lumber changes shape as it dries. It shrinks, twists, and bows. Then the finish tells on the framing: popped fasteners, cracked drywall tape, wavy walls, and callbacks that nobody priced.

Here is the memory aid: 19 means not hidden. If the meter is over 19, the framing is not ready to disappear. I like that phrase because it turns the number into a field decision. It does not matter if the crew is ready. It does not matter if the delivery is already scheduled. If the wall is too wet, enclosure turns a temporary moisture problem into a concealed construction defect.

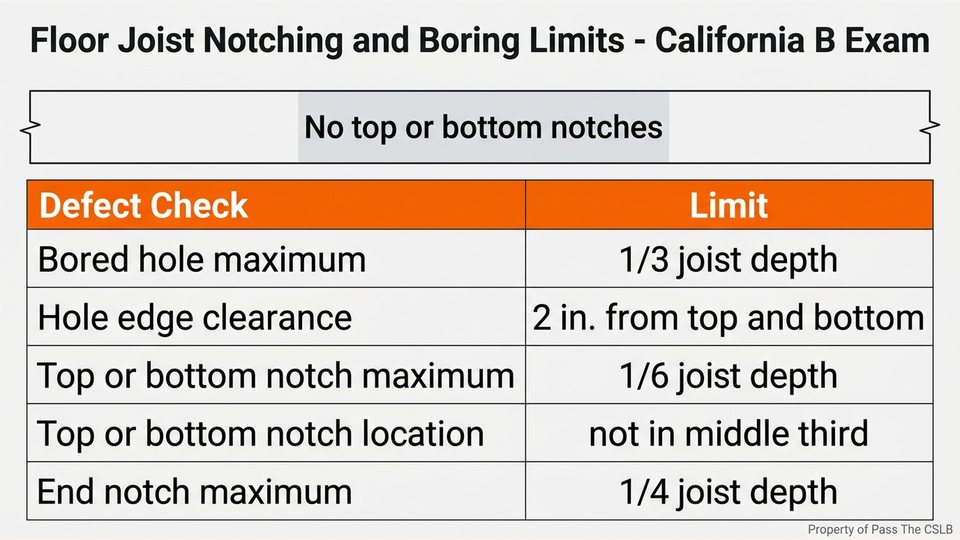

Now I want to move to the cuts that get made during rough in, because this is where good contractors catch bad geometry. The California Plumbing Code Appendix C101 gives limits for notching and boring wood framing members. The numbers are not random. They come from how wood members carry load.

A joist is like a simple bridge. The top fibers are being squeezed, the bottom fibers are being stretched, and the middle of the span is where bending demand is highest. If somebody cuts a notch in the bottom of the joist near the middle of the span, that notch is right where the tension side needs continuous wood fibers the most. It is like starting a tear in a loaded strap.

A bored hole is different when it stays near the neutral axis, the center zone of the joist depth. That is why a centered hole can be allowed within limits, while a notch at the wrong place can be much more dangerous. The code is really telling you where the wood can afford to lose material and where it cannot.

Floor Joist Notching and Boring Limits - California B Exam. Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.
Floor Joist Notching and Boring Limits - California B Exam - Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.

Use this joist chart as a field filter. Bored holes in joists cannot exceed 1/3 of the joist depth, and they cannot be within 2 in. of the top or bottom. Top or bottom notches cannot exceed 1/6 of the joist depth. Those top or bottom notches are not allowed in the middle third of the span. End notches are limited to 1/4 of the joist depth.

Here is a practical example. A nominal 2x10 joist has an actual depth of 9 1/4 in. 1/3 of that is just over 3 in. So a 4 in. bored hole for a pipe is not a small adjustment. It exceeds the allowed limit. The hole may look clean, the slope may work, and the pipe may fit perfectly, but the framing member has been compromised beyond the conventional allowance.

My memory line is thirds for holes, sixths for notches, and protect the middle third. Holes get the larger fraction because they can pass through the center. Notches get the smaller fraction because they cut in from an edge where stresses are high. The middle third is the danger zone for notches because the span wants to bend there.

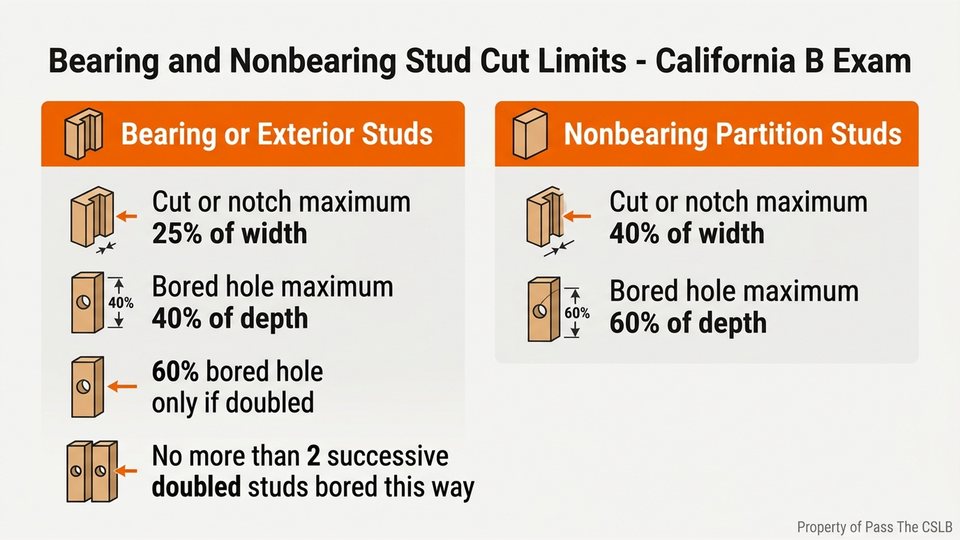

Studs have their own set of limits, and the first question is whether the wall is bearing or nonbearing. In exterior walls and bearing partitions, a wood stud may be cut or notched only up to 25% of its width. A bored hole in a bearing stud is limited to 40% of the stud depth. In a nonbearing partition, the allowances increase: cutting or notching may go up to 40% of the width, and bored holes may go up to 60% of the depth.

There is one special bearing wall rule worth keeping separate. A 60% bored hole can be permitted in a bearing wall when the stud is doubled, but no more than 2 successive doubled studs are bored that way. That is not a casual permission slip. It is a limited condition, and it needs to be recognized exactly.

Bearing and Nonbearing Stud Cut Limits - California B Exam. Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.
Bearing and Nonbearing Stud Cut Limits - California B Exam - Visual study chart for Recognizing Active Construction Defects in the Field in the Pass The CSLB audio lesson.

On this stud chart, the pattern is easy to see. Bearing walls get the tighter limits because they carry load. Nonbearing partitions get more room because they are not carrying the same structural demand. My memory phrase is bearing walls bargain harder. They give up less wood.

This is also where unauthorized substitutions show up. California Business and Professions Code Section 7109 treats a willful departure from accepted trade standards, or a willful departure from plans and specifications in a material respect without proper consent, as cause for discipline. The word willful can trap people. In this context, it does not have to mean evil intent. If a contractor intentionally makes the substitution or intentionally disregards the plan, the act can be willful even if the motive was to help the job.

Imagine the plan calls for a particular rated structural sheathing at a shear wall, with a specific nail spacing. The crew runs short and installs another panel because it is on site, then adjusts the nailing because it feels close enough. That is not field creativity. That is an active defect. The correct move is to stop, compare against the approved plans, obtain the required consent and design professional approval if a change is proposed, or replace the work with the specified assembly.

Now comes the boundary that protects the contractor as much as the owner. A General Building contractor can recognize out of tolerance work and coordinate correction. That does not mean the contractor can engineer the repair.

Business and Professions Code Section 5537 describes the conventional light wood frame area where unlicensed design is allowed under specific limits, but when work deviates from conventional framing, the repair documents for that portion need the stamp and signature of a licensed design professional. In plain field language, if a structural member has been cut beyond the allowed limits, or an engineered component has been damaged, I do not invent a repair detail out of pride.

That means no casual plywood gusset on a damaged manufactured truss. No made up sistering detail for an over notched joist when the code allowance has already been exceeded. No guess that extra nails and glue will restore the load path. The contractor's job is to identify the defect, protect the project from concealment, notify the right people, and get the repair designed by the qualified person.

I like this memory line: recognize, do not redesign. Recognize the defect. Coordinate the correction. Do not cross into engineering unless you are licensed to do that work. That is not weakness. That is professional discipline.

Let me pull the whole episode into one field checklist. 1st, active defects are problems that are still visible and correctable before they become hidden liabilities. 2nd, the qualifier's direct supervision includes checking workmanship and managing technical and administrative decisions. 3rd, pre cover approval is a hard hold point, because structural framework and reinforcing steel cannot be concealed before the enforcing agency approval. 4th, wet framing over 19% moisture content is not ready to enclose. 5th, joist holes, joist notches, and stud cuts have exact limits, and the middle third of a joist is protected from top and bottom notches. 6th, an unauthorized substitution can be a willful departure even when the motive is not malicious. 7th, out of tolerance structural repairs require the right design professional when the work has moved beyond conventional limits.

The big idea is that a defect is cheaper when it is visible. I want you to build that instinct. Walls open, eyes open. Before cover, slow down. Before substitution, get consent. Before repair, know whether you are coordinating construction or designing structure.

There is an audio practice quiz for this specific episode, and I want you to use it while the material is still fresh. It is audio based: the questions are read aloud, and you answer by tapping, which is made for people studying on the go, in the truck, between job sites, or after a long day when reading another page is not happening. Go to the description below this video. You will see a link that says PassTheCSLB. Tap it. It will take you straight there. Comment below with any questions about active defects, pre cover inspections, moisture readings, framing cut limits, substitutions, or the design professional boundary. And subscribe so I can help you stay on track through every episode until you get your license.
