Compaction, Subbase, and Soil Preparation Before Foundations
August 11, 2026
Test Your Knowledge
3 questions - Audio-based - Study on the go
Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.
This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.
This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.
A foundation can be formed correctly, reinforced correctly, and poured correctly, yet still move if the soil below it was never prepared and verified. That is the central idea I want you to hold onto. Concrete does not erase a weak subgrade. It transfers building loads into whatever support is underneath it.
The subgrade is the prepared soil surface that supports the next part of the work. Depending on the project, that next part may be compacted fill, a subbase, a footing, or a slab assembly. A surface that looks flat and feels hard under a boot is not automatically acceptable. The real questions are what material is present, how deep the fill is, whether the moisture condition is workable, what density standard applies, and who must verify the result.
Based on the published CSLB study outline, earthwork and surveying falls within testable material for the California B General license. The contractor-level skill is not pretending to be the geotechnical engineer. It is recognizing when the work crosses into specialist control, sequencing the work correctly, and refusing to cover a condition before the required verification is complete.
Site preparation begins by removing material that cannot provide dependable support. Vegetation, topsoil, roots, stumps, and foreign material do not become structural soil merely because a grader passes over them.
The California Building Code requires stumps and roots to be removed to a depth of not less than 12 in. below the ground surface in the area the building will occupy. I want you to notice that this is not simply a direction to cut everything flush. The concern is what remains below the surface inside the building footprint.
Organic material changes over time. Roots and buried vegetation can decay and leave voids. If support disappears in one area while the surrounding soil remains firm, the foundation may settle unevenly. The practical lesson is straightforward: a clean-looking pad is not enough if unsuitable material remains where the structure will bear.
Imagine a contractor who scrapes the site level, removes the visible stump, and leaves the root mass buried just below grade. The pad may look finished. The hidden condition has not been corrected. The better field decision is to expose and remove the unsuitable material to the required depth, replace it with acceptable material under the governing requirements, and make the area available for inspection before it is concealed.
I also want you to separate clearing from compaction. Clearing removes unsuitable material. Compaction densifies acceptable material. One operation cannot substitute for the other. A roller cannot turn decaying roots into competent support.
The next decision is the depth of fill beneath a shallow foundation. This is where the number twelve becomes a major coordination trigger.

The chart separates the two basic conditions. When compacted fill supporting a shallow foundation is 12 in. deep or less, an approved soils report may not be required, provided the in-place dry density reaches at least 90% of the maximum dry density at optimum moisture content under the modified Proctor method identified as ASTM D1557.
When that fill is greater than 12 in. deep, an approved geotechnical investigation is required. That investigation establishes the project-specific requirements, including site preparation, fill material, maximum dry density, and lift thickness.
The important phrase is total fill depth beneath the shallow foundation. Do not confuse the thickness of one lift with the total depth of fill. Suppose a crew places two compacted lifts, each 7 in. thick. Each lift is less than 12 in., but the total fill depth is 14 in. The total condition has crossed the 12-in. trigger.
That is exactly the kind of field-supervision distinction a General B contractor must catch before the work gets buried under forms, reinforcing steel, and concrete. The contractor does not solve the geotechnical design. The contractor recognizes the trigger, stops the uncontrolled placement, and coordinates the approved investigation and inspection requirements.
The 12-in. threshold is not permission to ignore every other project condition when the fill is shallow. Plans, approved reports, site conditions, local enforcement, and other code triggers may still control. The safe exam-prep distinction is narrower: fill greater than 12 in. beneath a shallow foundation triggers the approved geotechnical investigation described in the California Building Code, while shallow fill may use the code baseline only when the stated conditions are satisfied.
Now I want to focus on what 90% compaction actually means. It does not mean the soil is 90% solid. It does not mean the roller completed 90% of its planned passes. It does not mean the surface feels 90% hard.
The laboratory procedure establishes a maximum dry density for the soil at an optimum moisture content. The field density is then compared with that laboratory value. Under the baseline condition described for shallow compacted fill, the in-place dry density must be at least 90% of that maximum dry density using the modified Proctor method, ASTM D1557.
This distinction matters because a visual judgment cannot produce the required ratio. A contractor may observe the work, monitor the sequence, and recognize obvious soft or pumping areas, but the contractor does not replace the required test with experience or confidence.
The research identifies a common confusion between the standard Proctor method and the modified Proctor method. For the California code baseline discussed here, the cited method is ASTM D1557, the modified Proctor method. A report or test result tied to a different method is not something the contractor should casually treat as interchangeable.
A Special Inspector verifies the in-place dry density where the code requires that verification. That remains important even when a full approved geotechnical report is not required for the shallow fill condition. The absence of a full report does not mean the contractor gets to self-certify the soil.
The General B responsibility is coordination. I schedule the earthwork so the inspector can observe or test at the required time. I make sure the fill is not covered before acceptance. I keep the report and test documentation connected to the correct area and elevation. I do not let schedule pressure turn an unverified condition into a hidden condition.
A failed density result is not merely paperwork trouble. It means the placed material has not demonstrated the required relationship to the laboratory maximum. The proper response comes from the governing report, inspector, and design professionals. It may require moisture adjustment, additional compaction, removal and replacement, thinner lifts, or another corrective step. The contractor should not invent a cure without the responsible specialist.
Density and moisture are connected. Soil contains solid particles, air, and water. Compaction pushes particles closer together and reduces air voids. The right amount of moisture helps particles move past one another into a denser arrangement.
Too little moisture can leave too much friction between particles. Too much moisture creates a different problem. Water occupies the voids and does not compress the way air does. When heavy equipment loads an over-saturated subgrade, the surface may yield, wave, or ripple instead of tightening. Contractors commonly describe that movement as pumping.

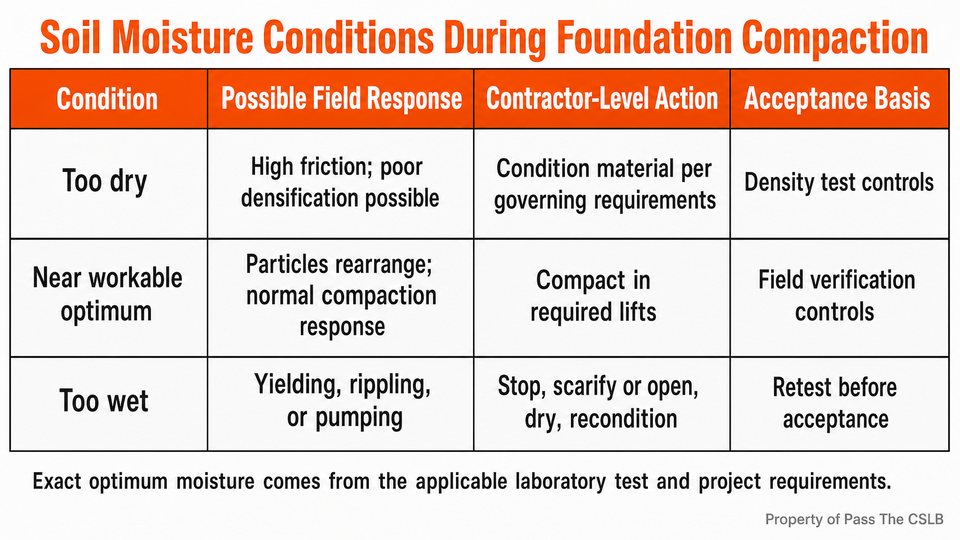

The comparison on screen shows the practical difference among soil that is too dry, near the workable moisture condition, and too wet. The exact moisture target belongs to the test method and the project requirements. The contractor-level lesson is to recognize behavior that says the material is not responding normally.
Suppose a water truck operator heavily soaks the foundation pad just before the roller arrives. The drum makes a pass and the ground moves like a slow wave. More passes do not squeeze the water out by force. Continuing to roll can keep disturbing the area instead of producing a stable surface.
A source-backed corrective sequence is to stop compaction, scarify or open the soil, allow the moisture content to decrease, recondition the material as directed, and then resume compaction and testing. The key judgment is to stop treating a moisture problem as if it were only a lack-of-effort problem.
A proof-roll observation can also reveal yielding or unstable areas when the prepared surface is loaded. I would not treat that observation as a substitute for required density testing. It is a field warning that helps the contractor identify where more evaluation may be needed. Acceptance criteria still come from the governing plans, report, inspector, and authority.
This is the central cause-and-effect loop of the episode. Proper compaction reduces air voids and improves support. Correct moisture helps that densification happen. Excess water blocks the process and can produce pumping. The field choice is to correct the condition before accepting or covering the subgrade.
Residential slab-on-ground work adds another set of numbers that contractors often mix up with the 12-in. geotechnical trigger.

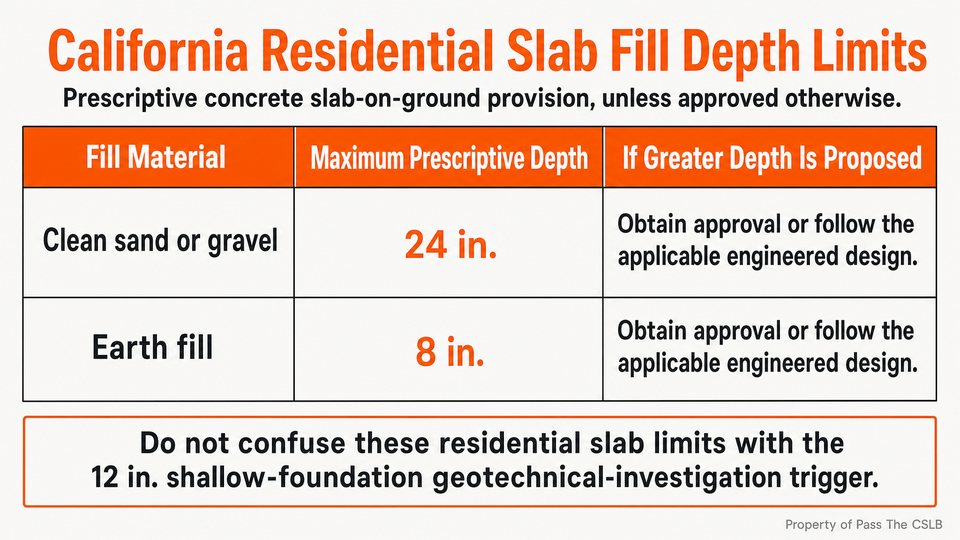

Under the prescriptive California Residential Code provision identified in the source report, fill beneath a residential concrete slab-on-ground is limited to 24 in. for clean sand or gravel and 8 in. for earth, unless approved otherwise.
These numbers answer a different question from the general 12-in. trigger. The 8-in. and 24-in. limits distinguish prescriptive residential slab fill by material. The 12-in. rule addresses when fill supporting shallow foundations becomes deep enough to require an approved geotechnical investigation under the California Building Code.
Do not blend the numbers into one universal rule. Earth fill being limited to 8 in. in the residential slab provision does not mean every project in California has an 8-in. maximum. Clean sand or gravel being allowed up to 24 in. under that prescriptive provision does not erase a project-specific geotechnical requirement.
The General B contractor must identify which code path, approved plan, soils report, and project condition actually govern the work. When the design is engineered or the authority has approved another condition, the approved documents control the field sequence. The contractor's job is to follow the applicable direction, not to select whichever number is most convenient.
A useful memory connection is material, depth, and approval. First identify the material. Then identify the total depth. Then confirm whether the prescriptive rule applies or whether an approved design or geotechnical report controls.
Earthwork succeeds when the responsibilities stay clear.

The General B contractor coordinates the workflow. The geotechnical professional establishes project-specific soil and fill requirements when an approved investigation is required. The Special Inspector verifies the required field density. The competent person manages excavation hazard inspections and must have the knowledge and authority to identify hazards and take prompt corrective action.
I like the conductor comparison because it keeps the license boundary clear. The conductor does not write every part and does not play every instrument. The conductor makes sure the right specialist is present at the right time and that one operation does not move forward before the previous requirement is satisfied.
That means I do not choose a load-bearing value from memory. I do not operate a density gauge and declare my own test result unless I am separately qualified and authorized for that role. I do not call any foreman a competent person merely because of job title. I verify that the designated person actually has the required knowledge and authority.
The contractor's coordination decisions are still substantial. I confirm whether the soils report is required and available. I make sure the grading subcontractor has the current requirements. I coordinate lift placement with the inspector. I stop the work when the field condition conflicts with the report or when required observation cannot occur. I preserve the records needed for inspection and closeout.
A frequent mistake is to think specialist involvement reduces the General B contractor's responsibility. In practice, specialist involvement increases the need for careful sequencing. The contractor is the person who keeps the excavation, fill placement, testing, forms, reinforcing steel, and concrete work from colliding.
Soil preparation also puts workers next to moving equipment and inside excavations. The safety rules cannot be separated from the earthwork sequence.
Before opening an excavation, the approximate location of subsurface installations must be determined. The source report identifies sewer, telephone, electric, and fuel installations as examples. When excavation will occur within 10 ft. of a high-priority subsurface installation, the required notification procedure must be followed.
That is a pre-excavation responsibility. Discovering the utility after the bucket contacts it is not a locating method. The contractor must build the notification and locating work into the schedule before production excavation begins.
Earthmoving vehicles operating with blocked rear vision must have an automatic backup alarm or equivalent protection. A busy grading operation is loud, dusty, and full of changing blind spots. The equipment requirement is not replaced merely by assuming workers will stay out of the way.
Excavations and trenches require inspection by a designated competent person daily before work begins, as needed during the shift, and after every rainstorm or other hazard-increasing event. Rain can change soil strength, create water accumulation, and produce sloughing or tension cracking. A trench that appeared acceptable before the storm is not automatically acceptable afterward.
Imagine a crew returning on Monday after heavy weekend rain. The forms and reinforcing steel are ready, and the schedule is already behind. The correct sequence is still to keep workers out until the competent person performs the new inspection and any hazardous condition is corrected.
This is a good example of contractor judgment under pressure. The rule is not satisfied by remembering that an inspection happened last week. The current excavation must be evaluated under the current condition.
I want to pull the entire field sequence together without turning it into a rigid checklist for every project.
First, determine the approximate location of subsurface installations and complete any required high-priority notification. Second, identify the governing plans, approved geotechnical report, code path, and inspection requirements. Third, remove vegetation, roots, stumps, topsoil, and foreign material as required, including the 12-in. root and stump removal depth within the building footprint.
Next, determine the material and total depth of any proposed fill. If fill beneath a shallow foundation will exceed 12 in., coordinate the approved geotechnical investigation before uncontrolled placement continues. If the project uses a prescriptive residential slab provision, distinguish the 8-in. earth limit from the 24-in. clean sand or gravel limit, unless another condition is approved.
Then place and condition the material under the governing requirements. I do not invent a lift thickness because the source report says the geotechnical investigation may specify it. I watch for obvious instability, pumping, or a moisture condition that prevents normal compaction. I schedule the Special Inspector so required density verification occurs before the work is covered.
At the same time, I maintain the excavation safety program. I verify the competent person inspections, including the fresh inspection after rain. I verify required backup protection on equipment with blocked rear vision. I keep workers out of unsafe areas and stop conflicting operations.
Only after preparation, compaction, verification, and safety conditions are satisfied should the next concealed stage move forward. That may be forms, reinforcing steel, utilities, vapor control, or concrete, depending on the assembly. The exact sequence comes from the project documents, but the principle stays the same: do not cover uncertainty.
A useful memory phrase is clear it, coordinate it, compact it, confirm it. Clear unsuitable material. Coordinate the engineer and inspector when required. Compact under the correct moisture and placement requirements. Confirm the result before concealment.
Here is the final distinction I want you to remember. Compaction is not a visual finish. It is a controlled and verified support condition.
Remove stumps and roots to the required 12-in. depth in the building footprint. Recognize the greater-than-12-in. fill trigger beneath shallow foundations. Keep the 90% modified Proctor baseline tied to ASTM D1557. Distinguish the residential slab limits of 8 in. for earth and 24 in. for clean sand or gravel, unless approved otherwise. Coordinate the Special Inspector, the geotechnical professional, and the competent person without crossing their roles.
When the soil pumps, do not reward it with more blind rolling. Stop and correct the moisture condition under the governing direction. Before excavation, locate subsurface installations and complete required notification. During earthwork, protect workers with the required equipment safeguards and current excavation inspections.
I made an audio practice quiz specifically for this episode's soil preparation, fill depth, compaction, inspection, and safety material. It is audio-based, so the questions are read aloud and you answer by tapping. I built it for people studying while driving, working, or moving through a busy day. Go to the description below this video. You will see a link that says PassTheCSLB. Tap it. It will take you straight there. Comment below with any questions about the material I covered. Subscribe so I can help you stay on track through every episode until you get your license.
Study with practical, source-backed CSLB B General lessons as I build out the public topic path one audio lesson at a time.
