Countertop Templating and Installation Sequencing

September 12, 2026

Use this for viewing completed on YouTube's website or app.

Test Your Knowledge

3 questions - Audio-based - Study on the go

Mapped to the General B study path

Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.

Related study paths
Source & Confidence

This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.

Official CSLB topicProject Management - mapped to the public CSLB B General Building study-guide areas.
California rule verifiedRule, code, permit, safety, minimum, and maximum claims are treated as California-source claims and should be backed by official/public California or CSLB-referenced sources.
Background explanationStories, examples, analogies, and memory aids help busy learners retain the source-backed concepts without sitting in a classroom.
Needs re-checkFor live job, legal, safety, permit, plan, specification, or manufacturer-instruction decisions, verify the current source and follow the AHJ.
Last reviewedSeptember 10, 2026

This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.

A countertop template is not a rough estimate. It is a record of the finished space that the fabricator will use to make a rigid product. If the cabinets move after that record is taken, the template can be perfectly accurate and the finished countertop can still be wrong for the room. That is the heart of this lesson: freeze the physical conditions first, verify them, and only then release the template.

This is a testable concept based on the published CSLB study guide because cabinetry and millwork sit within finish trades, while coordination and safety run across the General Building contractor's work. I am staying on the supervision side of that boundary. I am not teaching specialty stone fabrication. I am teaching the decision about when the site is ready for the fabricator and what must remain controlled afterward.

A field template captures actual jobsite geometry. Walls may not be perfectly square. A cabinet run may meet an end panel, a tall cabinet, a column, or an appliance opening. Sink and fixture locations have to agree with the selected products. The templater records those finished relationships so the fabricated top arrives with the intended shape and openings.

That makes templating a commitment point. Imagine a contractor who schedules the templater while one base cabinet is only temporarily positioned. The crew moves that cabinet later to improve a door gap. Nothing about the original measurement procedure had to be careless. The problem is that the measured condition no longer exists. A seam can shift, an overhang can change, or a sink opening can stop lining up with the cabinet below.

I use one simple question before authorizing the visit: could any relevant dimension still change? If the honest answer is yes, the work is not ready. The schedule pressure may be real, especially when fabrication lead time begins only after the field measurement. But an early template does not truly save time when it creates a second measurement, a revised fabrication order, or a field modification.

The release point belongs after the base casework is permanently installed and secured, not while the installer is still deciding where the final plane will land. The selected sink and other required openings must be known. Finished end conditions must be settled. Any support that depends on concealed blocking or cabinet construction must already be coordinated through the approved project information.

I want to emphasize the distinction between measuring and approving. The specialty fabricator measures the work within that fabricator's scope. The General Building supervisor coordinates the trades and decides whether the surrounding work is actually ready to be measured. Calling the templater does not transfer responsibility for unfinished prerequisites.

The cabinet run is the foundation of the countertop. The source material gives a specific casework tolerance: plumb and level within 1/8 in. over 96 in. That is a memorization number, but it also describes a practical control. The fabricator should receive one stable, consistent support plane rather than a row of cabinet tops wandering up and down.

Level describes the horizontal condition. Plumb describes the vertical condition. A long run can also have individual cabinet tops that do not share the same plane even when each box looks acceptable by itself. I would verify the whole run, not simply place a short level on one cabinet and declare the room ready.

The floor has to be dealt with before the cabinet installer is forced to hide a larger problem at the toe base. The source report states that when floor variation exceeds 1/2 in., the floor must be structurally corrected before cabinet installation and that shimming the toe base beyond 1/2 in. is unacceptable under the cited woodwork standard. That means the supervisor needs to find the variation early enough to grind, fill, level, or otherwise correct the supporting condition through an appropriate approved method.

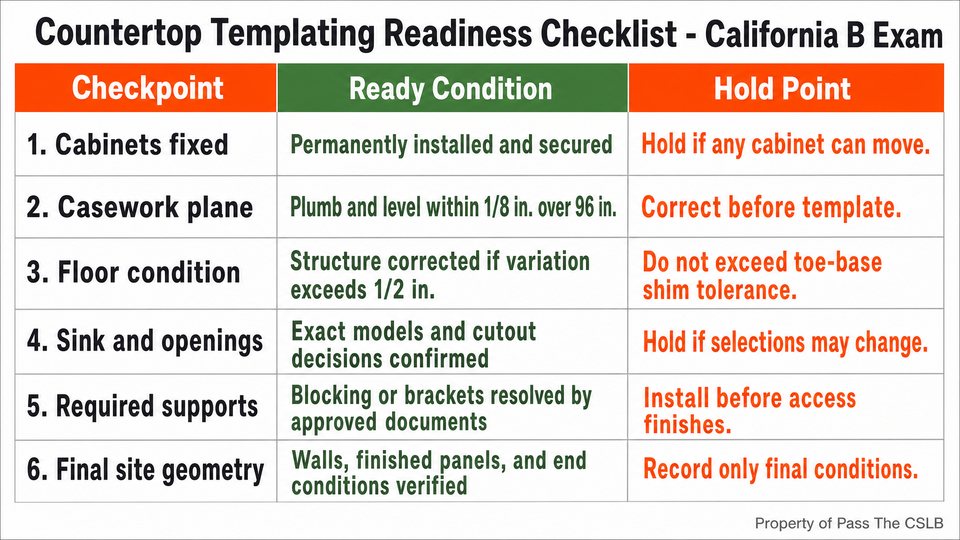

Countertop Templating Readiness Checklist - California B Exam. A flat six-row checklist table showing the field conditions a General B supervisor verifies before authorizing a countertop template.
Countertop Templating Readiness Checklist - California B Exam - A flat six-row checklist table showing the field conditions a General B supervisor verifies before authorizing a countertop template.

I put the readiness checks side by side in this chart. The order matters. First, confirm that the cabinets are fixed. Second, verify the cabinet plane against the 1/8 in. over 96 in. tolerance. Third, resolve a floor variation that exceeds 1/2 in. instead of asking excessive shims to conceal it. Then confirm the openings, supports, and final site geometry. A hold at this point is cheaper than pretending an unresolved condition is final.

The reason is not that stone is weak under every kind of load. The practical concern is that a rigid countertop does not behave like flexible trim. High bearing points, gaps in support, and a moving cabinet run can concentrate stress or interfere with seams and cutouts. The exact outcome depends on the material and assembly, so I would not promise that every uneven cabinet causes a crack. I would say that an out of tolerance support condition creates avoidable fit and performance risk and must be corrected before release.

Here is a useful field distinction. A cabinet can look level enough for doors to operate and still fail the specified tolerance across the full run. Appearance does not replace measurement. The supervisor's job is to verify the condition with an appropriate long level, straight reference, or calibrated measuring method and document the correction before the templater records it.

Once the casework plane is ready, the openings become the next coordination point. A sink cutout is not just a rectangle centered over a cabinet. It depends on the exact sink model, the intended mounting condition, the relationship to the cabinet, and the space needed for the assembly below. Faucet holes, accessory holes, and nearby wall or backsplash conditions can also affect what the fabricator needs to record.

I would not release a custom cutout from a verbal description such as standard sink. I would match the selected product information, the approved submittal or shop drawing when one is required, and the actual cabinet opening. If a product changes after templating, I would treat that as a dimensional change until the fabricator confirms otherwise.

Overhang support needs the same discipline, but the research report marks the proposed universal overhang numbers as background only. I would not turn those numbers into a California rule. Instead, I would verify support requirements from the approved design, the selected material and fabricator information, manufacturer instructions where applicable, and engineering when the project requires it. If brackets, corbels, legs, or concealed blocking are required, their attachment path must be coordinated before the countertop arrives and before finishes close access to the framing.

That is a sequencing lesson, not a stone design lesson. The supervisor makes sure the decision is resolved, the responsible trade has usable backing, and the installed work agrees with the approved information. The specialty expert determines fabrication details within that expert's scope.

Lead time begins after reliable information is released. If the cabinet layout, sink, wall finish, or support condition is still moving, the apparent start of fabrication is false progress. I would rather show the schedule honestly: cabinet installation, tolerance verification, product and support confirmation, field template, fabrication, countertop installation, and then the dependent finish connections. Compressing the sequence by overlapping incompatible work merely hides risk inside the schedule.

Accessible sinks add a geometry check that needs to happen before stone is cut. Under the cited California Building Code provisions, the front of the higher of the sink rim or counter surface is limited to a maximum of 34 in. above the finish floor. The required knee clearance is at least 27 in. high and extends at least 8 in. deep at that height.

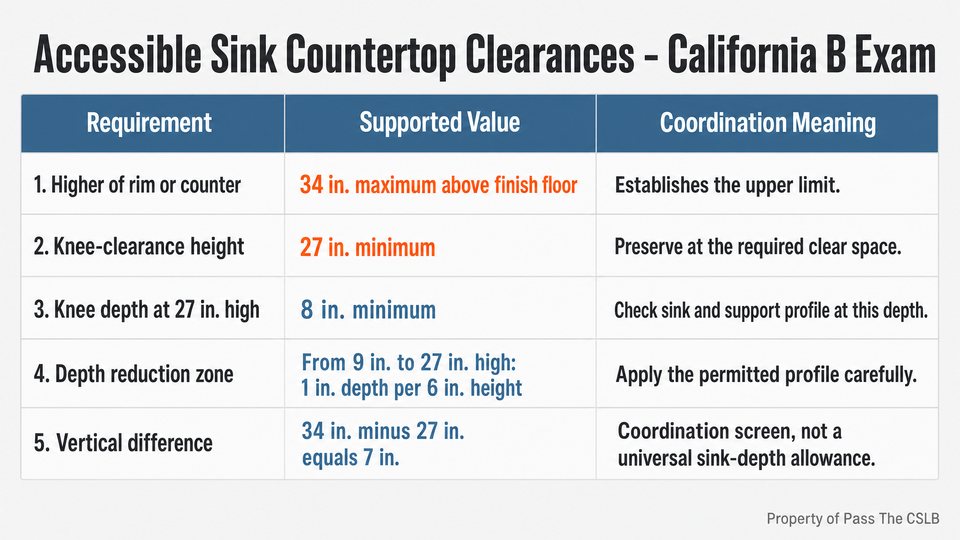

Accessible Sink Countertop Clearances - California B Exam. A flat five-row reference table for California accessible sink and countertop coordination. Use columns labeled Requirement, Supported Value, and Coordination Meaning.
Accessible Sink Countertop Clearances - California B Exam - A flat five-row reference table for California accessible sink and countertop coordination. Use columns labeled Requirement, Supported Value, and Coordination Meaning.

The chart shows the important numbers without turning them into a picture of one universal sink. 34 in. is the upper limit for the higher rim or counter surface. 27 in. is the minimum knee clearance height. At that height, the clearance extends at least 8 in. in depth. Between 9 in. and 27 in. above the floor, the permitted knee clearance depth may reduce at a rate of 1 in. in depth for every 6 in. of height.

The subtraction is memorable: 34 minus 27 equals 7. I treat that 7 in. difference as an early coordination screen at the relevant clearance plane. I do not treat it as permission to install any sink whose catalog depth is less than 7 in. The actual profile depends on where the bowl, counter, supports, drain components, and required clearance envelope occupy space. The shop drawing has to show that geometry.

Suppose a hypothetical shop drawing places the counter surface at 34 in., but the underside of the sink drops to 26 1/2 in. at a location where 27 in. of knee height must remain. The drawing misses the required height by 1/2 in. Raising the counter is not available because the counter is already at the maximum. That conflict must go back for a compliant fixture, support, or layout solution before templating and fabrication.

This is where people confuse knee clearance with toe clearance. The source material identifies 9 in. as the minimum toe clearance height, while 27 in. is the knee clearance height. Those numbers describe different portions of the clear space. Swapping them produces a drawing that may sound familiar but does not preserve the required profile.

I would coordinate accessibility from the finish floor, not from an unfinished slab or an assumed flooring thickness. I would also verify the higher of the rim or counter surface, because checking the easier of those two elevations can hide a violation. The practical move is to review the fixture cut sheet, millwork information, countertop thickness, supports, and plumbing arrangement together before any irreversible fabrication.

Installation day can create a different risk when a countertop needs trimming, grinding, or polishing. The California source material treats dry work on covered silica containing stone as an imminent hazard. For artificial stone containing more than 0.1% crystalline silica, and natural stone containing more than 10% crystalline silica, dry cutting and dry grinding on the jobsite are prohibited under the cited California rule.

California Countertop Silica Safety Controls - B Exam. A flat five-row comparison table contrasting prohibited stone-work practices with the required California control.
California Countertop Silica Safety Controls - B Exam - A flat five-row comparison table contrasting prohibited stone-work practices with the required California control.

This chart separates the prohibited shortcut from the required control. Covered cutting and grinding use effective wet methods. Dry sweeping and compressed air are not cleanup solutions for the resulting dust. The source report calls for wet cleanup or a high efficiency particulate air filtered vacuum. For high exposure trigger tasks, it also identifies a full face, tight fitting, powered air purifying respirator unless a stated exposure exception applies.

A standard dust mask by itself is not a substitute for the required system of controls. Water controls dust at the point where the tool creates it. Proper cleanup keeps settled material from becoming airborne again. Respiratory protection addresses the worker's remaining exposure under the rule. Each control handles a different part of the hazard.

Imagine a specialty installer discovers that a cutout needs a small adjustment and reaches for a dry grinder because the delivery crew is waiting. The amount of stone removed may look minor, but the supervisor does not measure compliance by how impatient the schedule feels. I would stop that task, confirm the material and applicable requirements, and allow work to resume only with the required methods, equipment, and respiratory protection in place.

The same discipline applies after the cut. Dry sweeping can put fine settled dust back into the breathing zone. Compressed air can spread it through the work area. I would plan water, power, containment, cleanup equipment, and controlled access before an onsite adjustment begins. If compliant work cannot be performed in that location, the solution may be to return the piece to a suitable controlled facility rather than improvise in an occupied building.

The General Building lesson is supervision. A specialty subcontractor's presence does not make an observed unsafe condition someone else's coordination problem. I do not need to operate the grinder to recognize a prohibited dry process and stop it.

On installation day, I would begin by checking that the conditions recorded at templating still exist. The cabinets should not have moved. Finished panels and support components should be in place as coordinated. The selected sink and other cutout dependent products should still match the released information. The delivery path and work area should be ready so the crew is not forced into an unplanned field modification.

Next, I would coordinate placement and fit without treating force as a correction method. If the top does not seat as expected, the right response is to find the changed or out of tolerance condition. Pulling a rigid top down to a bad plane, cutting first and asking questions later, or moving cabinets after the fact can transfer one coordination error into several trades.

Connections that depend on the installed countertop follow the countertop installation and any required cure or manufacturer directed waiting period. That includes the final work around sinks and plumbing connections. I would use the approved installation information for the actual materials rather than invent one universal waiting time.

Before closing the phase, I would inspect the visible fit, seams, bearing condition, cutout relationships, required supports, and accessible clearance. If a field change occurred, I would make sure the responsible parties accepted and documented it. The goal is not paperwork for its own sake. The goal is to keep the fabricated piece, the supporting casework, the fixtures, and the code required space describing the same finished condition.

My memory connection is freeze, verify, release. Freeze means the cabinet run, openings, finished edges, and support decisions are no longer moving. Verify means measure the casework tolerance, address the floor, check the product information, review accessibility, and prepare the required silica controls for any onsite work. Release means authorize the field template and fabrication only after those checks agree.

If I remember only one cause and effect, I remember this: the template records geometry, but it cannot freeze the jobsite. The supervisor freezes the jobsite condition before the template is taken. Any relevant change afterward has to be communicated back to the fabricator rather than hidden and hoped away.

I would use 5 final questions. Are the cabinets permanently secured? Is the full run within 1/8 in. over 96 in. for plumb and level? Has a floor variation beyond 1/2 in. been properly corrected? Do the sink, openings, accessibility profile, and required supports agree with the approved information? Can any onsite stone work and cleanup be performed with the California required silica controls? If one answer is no, I have found the hold point.

That is competent General Building supervision: not trying to perform every specialty task, but making sure each trade receives stable conditions, accurate information, and a safe sequence.

I made an audio practice quiz specifically for this episode on countertop templating and installation sequencing. It is audio based. The questions are read aloud, and you answer by tapping, so it works for people studying while driving, working, or otherwise on the go. Go to the description below this video. You will see a link that says PassTheCSLB. Tap it. It will take you straight there. Comment below with any questions about what I covered. Subscribe so you can stay on track through every episode until you get your license. I am rooting for you, and I will keep helping you turn each rule into a clear field decision.
