Plaster Curing and Environmental Controls
September 19, 2026
Test Your Knowledge
3 questions - Audio-based - Study on the go
Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.
This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.
This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.
Fresh cement plaster does not become strong because the wall looks dry. It becomes strong because water remains available long enough for cement and water to react. That reaction is hydration. This is the central idea I want you to carry through the entire lesson. When I supervise exterior Portland cement plaster, I am not trying to help it dry as fast as possible. I am protecting the moisture that the material needs in order to cure.
That distinction changes real field decisions. Sun, low humidity, and wind can pull water from a fresh coat too quickly. Cold can slow early strength development, and freezing can disrupt the young cement matrix. A rushed schedule can place the finish coat over a brown coat that is still moving. None of those conditions is solved by saying the wall feels hard at the surface. I have to manage the material, the weather, the sequence, and the people who may unknowingly undo the protection after the plaster crew leaves.
The General Building boundary matters here. I coordinate environmental controls, schedule the required intervals, check inspection points, and recognize conditions that call for a stop. The plaster specialist controls the application technique. I do not need to turn a General Building lesson into a lesson on working a hawk and trowel. I need to know when the assembly is ready, when it is not ready, and what must remain protected.
Drying and curing sound similar in casual jobsite talk, but they point in opposite directions for fresh cement plaster. Drying means water is leaving by evaporation. Curing means the cement is using water through hydration to build its hardened structure. Some evaporation will occur, but premature moisture loss can interrupt the reaction before the coat has developed the strength it should.
Imagine setting a wet sponge in moving air. The air keeps carrying moisture away from the surface, so more moisture moves outward to replace it. Fresh plaster is not a sponge, but that simple picture helps explain why wind can be so aggressive. A wall may be in mild air temperature and still lose moisture rapidly because dry air is constantly sweeping the surface. The practical supervision question is not merely whether water was added once. It is whether the coat retained enough moisture for the required period under the conditions that actually existed.
I also separate cement plaster from gypsum plaster. Portland cement plaster is the exterior workhorse in this source material and can also serve certain wet interior conditions. Gypsum plaster belongs in dry interior applications and must not be used on exterior surfaces. The safe memory connection is simple: exterior Portland cement plaster needs curing control; gypsum stays inside and does not borrow the exterior cement-plaster schedule.
This is a testable concept based on the CSLB study guide because it affects sequencing, defect recognition, and supervision. It is not an invitation to guess what a particular exam form contains. I treat the published topic as a signal to understand the decision, not to memorize a supposed future question.

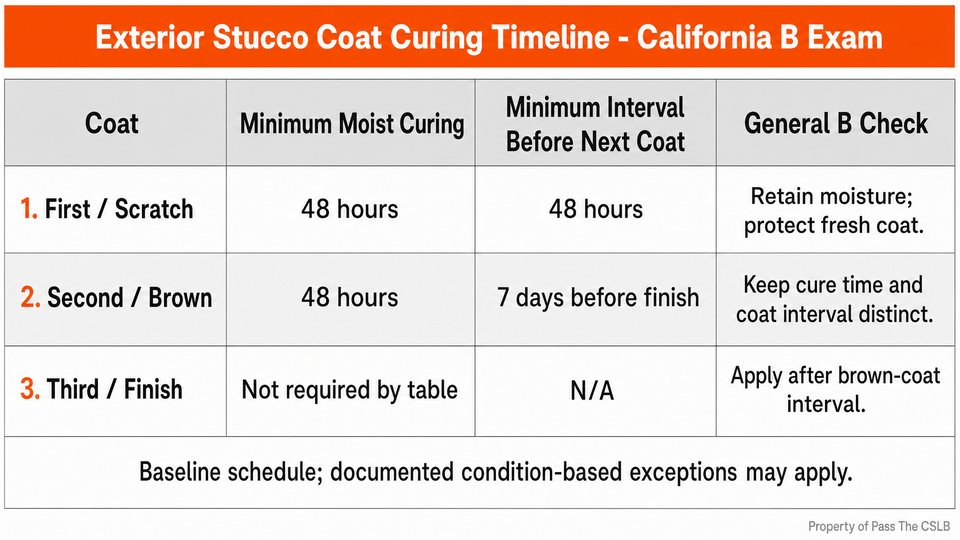

The baseline exterior assembly over wood or steel framing uses 3 coats over a water-resistive barrier and galvanized metal lath. Each coat has a different job, and the schedule is easier to remember when I connect the time to that job.

I put the baseline exterior schedule side by side because 2 numbers are often confused. The first coat is the scratch coat. It is embedded into the metal lath and scratched to provide a mechanical key for the next coat. The baseline table gives that first coat 48 hours of moist curing and a 48-hour minimum interval before the next coat.
The second coat is the brown coat. It establishes the true plane that will receive the finish. The brown coat also receives 48 hours of moist curing. The separate scheduling number is the minimum 7-day interval before the finish coat. One number protects early hydration. The other gives the base-coat system time before it receives the thin decorative surface.
I remember the distinction this way: 48 is about feeding the cure, and 7 is about respecting the sequence. That memory line is not a substitute for the governing table, but it keeps the 2 entries from trading places in my head.
The final coat is the finish or color coat. The source table does not assign it the same moist-curing entry as the scratch and brown coats. It comes after the brown-coat interval and provides the final texture and appearance. If the finish goes on too early, continued shrinkage and cracking in the base can become visible through the finish. That visible transfer is commonly called telegraphing.
I do not treat every field condition as identical. The governing provisions recognize condition-based exceptions. Active moist curing may not be required when job and weather conditions naturally retain moisture for the required time. A specific alternative method may also permit a shorter first-to-second-coat interval, but only when its stated conditions are satisfied. Those are controlled exceptions, not permission to erase the baseline schedule because a crew is behind.
Suppose a superintendent hears 48 hours and schedules the finish coat 2 days after the brown coat. That decision mixes the moist-curing entry with the coat interval. The calendar may look efficient, but the schedule is based on the wrong line. My correction is to identify both controls independently: the brown coat has a 48-hour moist-curing entry, and the finish follows the minimum 7-day brown-coat interval.
Weather control begins before a mixer turns. A reading taken at noon is not enough when the work must remain protected through the night. I check the current condition, the base, the forecast, the exposure of each elevation, and whether the planned protection can actually maintain the required environment.

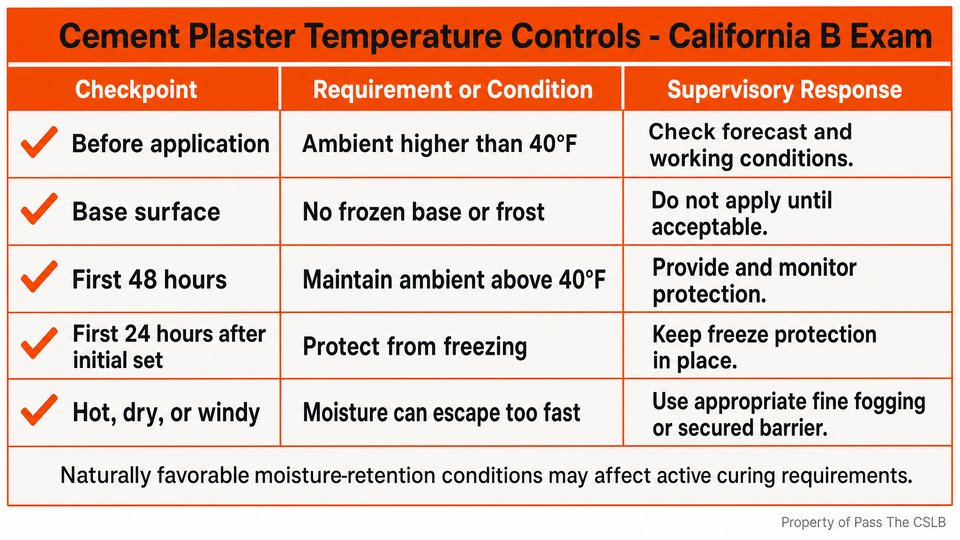

The baseline temperature rule says cement plaster is applied only when the ambient temperature is higher than 40°F. After application, the surrounding environment must remain above 40°F for at least 48 hours. The plaster must also be protected from freezing for at least 24 hours after initial set. Portland cement plaster is not applied to a frozen base or a base containing frost.
Those are related controls, but they are not interchangeable. Higher than 40°F at application is the starting condition. Maintaining higher than 40°F for 48 hours is the continuing environmental duty. Protecting from freezing for 24 hours after initial set is another time-based protection. The safest way to supervise the schedule is to keep each condition attached to its own clock.
Consider a hypothetical project where the afternoon air is 45°F, but the overnight forecast is 28°F. The current reading clears the application threshold, but the forecast shows that the required environment will not maintain itself. If reliable protection cannot keep the work compliant, I delay the application. Starting because the afternoon feels acceptable would transfer the entire risk into the first night.
The physical consequence is supported by ordinary material behavior. Hydration slows in cold conditions. If free water in fragile, uncured material freezes, the water expands and can damage the developing matrix. I do not need to claim that every cold exposure produces identical damage. I need to recognize that a coat exposed outside the required limits may be compromised and cannot simply be accepted because it later warmed up.
Heat creates the opposite-looking problem but attacks the same central need. In hot, dry, or high-wind conditions, evaporation can outrun the coat's ability to retain useful moisture. The report describes light fog spraying as a standard field approach and physical barriers such as secured plastic sheeting as a way to retain humidity when exposure is severe. The goal is not to blast the wall with water. The goal is a controlled environment that prevents premature moisture loss.
Imagine a hot south-facing wall with dry wind moving along the scaffold. A quick mist that vanishes immediately may not provide the needed retention. I would coordinate an appropriate fogging plan and, where suitable and safely installed, a secured barrier that reduces the drying exposure. I would also keep checking the condition. Environmental control is not complete when someone hangs plastic and walks away.

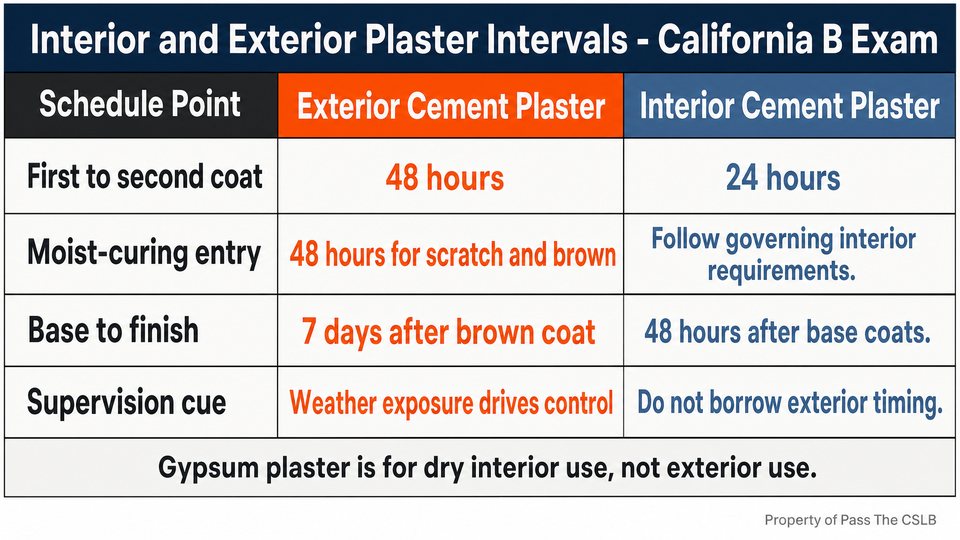

Interior and exterior cement plaster do not share one universal calendar. Borrowing the exterior schedule for every interior condition, or borrowing the shorter interior schedule for an exterior wall, creates avoidable errors.

For exterior cement plaster, the baseline first-to-second-coat interval is 48 hours, and the brown-to-finish interval is 7 days. The scratch and brown coats each carry a 48-hour moist-curing entry. For interior cement plaster, the minimum interval between coats is 24 hours, and the finish coat may be applied after 48 hours have elapsed over the base coats.
I keep the material name and location attached to every time value. If I hear 24 hours, I ask whether the subject is interior cement plaster or freeze protection after initial set. If I hear 48 hours, I ask whether the subject is moist curing, exterior coat timing, maintaining temperature, or interior base-to-finish timing. The number alone is not the knowledge. The number plus its condition is the knowledge.
Gypsum is a separate material decision. The source prohibits gypsum plaster on exterior surfaces. It also prohibits applying plaster directly to fiber insulation board. Gypsum lath or gypsum wallboard is generally not used as backing for cement plaster, with a limited exception described for horizontal ceilings, roof soffits, or interior walls when a water-resistive barrier and self-furred metal lath are used. For supervision, I verify the complete approved assembly rather than treating one familiar board product as a universal backing.
Environmental control also includes the path water takes after the building is occupied. Exterior stucco can absorb water. The water-resistive barrier and weep screed provide a managed path for drainage at the bottom of the wall. That path only works when later trades leave the termination exposed.

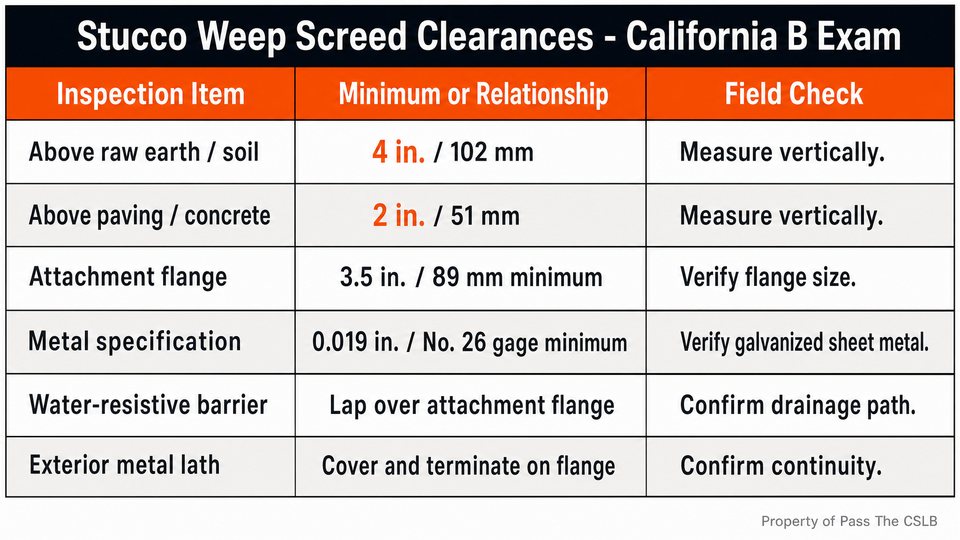

At a weep screed, the minimum vertical clearance is 4 in. above raw earth or soil and 2 in. above paved areas such as concrete. The attachment flange is at least 3.5 in. The metal is at least 0.019 in., identified in the source as No. 26 galvanized sheet gage. The water-resistive barrier laps over the attachment flange, and the exterior metal lath covers and terminates on that flange.
The supervision problem often arrives late. The plaster crew can leave a correct termination, and then a concrete crew can pour too high or a landscaping crew can raise the soil. The finish-trade detail has now become a coordination detail. If the screed is buried, drainage is obstructed and moisture can remain against the base of the assembly. That can contribute to wicking, moisture intrusion, material deterioration, and biological growth, depending on the surrounding conditions.
Suppose a planter is graded until soil sits 1 in. below the screed. The wall may look finished, but the earth clearance is 3 in. short. I stop the landscaping work and require the grade to be corrected before closeout. The memory connection is 4 over earth, 2 over paving. The reason the distinction matters is that soil can hold moisture directly against the wall termination.
Plaster supervision also reaches the temporary access equipment. The numbers differ by scaffold type and by the worker using a job-made ladder, so I keep the comparisons narrow.

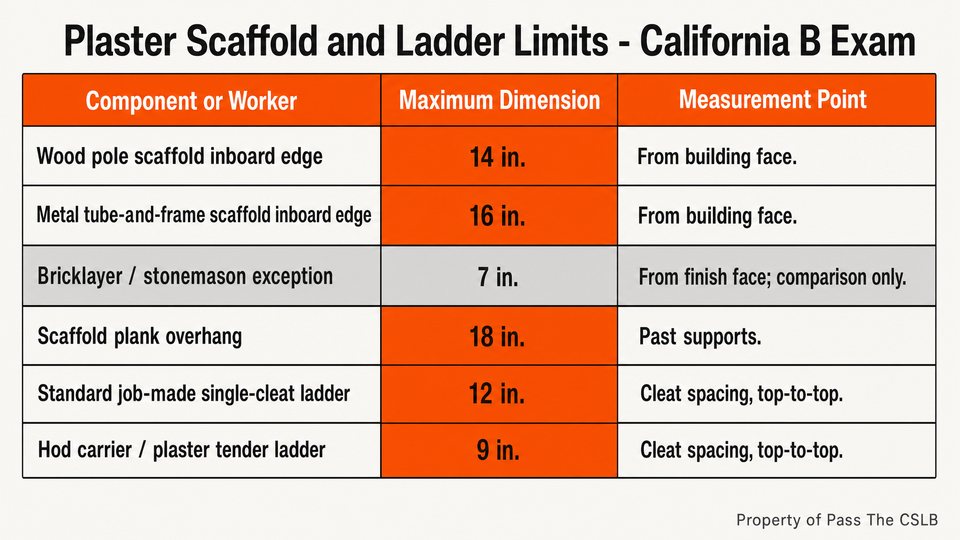

For the source rules summarized here, the inboard edge of a wood pole scaffold is no more than 14 in. from the building face. A metal tube-and-frame scaffold is no more than 16 in. from the building face. The 7-in. comparison belongs to the bricklayer or stonemason exception, not to plasterers. A scaffold plank extends no more than 18 in. beyond its supports.
For a standard job-made single-cleat ladder, cleats are spaced no more than 12 in. apart, measured top to top. A job-made ladder used by hod carriers or plaster tenders has the tighter maximum of 9 in., also measured top to top. I connect the smaller step to the burdened worker, but I still memorize the actual rule and measurement point.
These limits are not permission to ignore the rest of the safety order. They are the specific comparison facts supported by this report. My broader duty is to make sure the access system, loading, placement, and use comply with the applicable California safety requirements for the actual site.
The General Building contractor adds the most value by making stop-or-go decisions before a defect is concealed. I can organize those decisions around 4 checks: material, environment, time, and interface.
Material means I confirm what plaster system and backing are actually approved. Environment means I verify temperature, frost, sun, wind, and moisture retention. Time means I track moist-curing periods separately from intervals between coats. Interface means I inspect the places where another trade can defeat the assembly, especially the weather barrier, lath termination, paving, and finish grade.
Imagine a crew finishing a brown coat during extreme heat and dry wind. If I only record the completion date, I have managed the calendar but missed the material. I need a curing plan that responds to the exposure. Now imagine the same wall in cold weather. If I only check the temperature at application, I have managed one moment but missed the protection period. The correct supervisory habit is to connect the requirement to the full time window.
Documentation supports that habit. I can record the coat and completion time, observed environmental conditions, forecast, protection method, curing checks, and any approved exception. The research does not make one universal form mandatory, so I do not invent a paperwork rule. I use records to keep the schedule, subcontractor direction, and inspection readiness aligned.
The same thinking applies when someone proposes a proprietary fast-curing product or alternate interval. I do not assume that a sales sheet automatically replaces the baseline California provisions. I verify the approved documents, manufacturer requirements, and acceptance by the authority having jurisdiction when approval is required. An alternative is a documented path, not a verbal shortcut.
If I find a coat that may have frozen, dried prematurely, or received the finish too early, I do not hide the condition behind the next operation. I pause, document what occurred, and obtain an appropriate evaluation under the governing project requirements. The exact repair depends on the actual material, extent of damage, approved system, and responsible authority. Good supervision recognizes the limit of a general rule.
I want to leave you with one connected picture. Portland cement plaster needs moisture to hydrate. The scratch and brown coats each have a baseline 48-hour moist-curing entry. The exterior brown coat has a 7-day interval before the finish. Cement plaster begins only above 40°F, remains above that threshold for 48 hours, and stays protected from freezing for 24 hours after initial set. A frozen or frosted base is not acceptable.
Interior timing is different. Gypsum plaster stays off exterior surfaces. At the bottom of an exterior stucco wall, remember 4 in. over earth and 2 in. over paving. For the safety comparisons, remember 14 in. for the wood scaffold, 16 in. for the metal scaffold, and 9-in. top-to-top cleat spacing for a job-made ladder used by hod carriers or plaster tenders.
The heart of the lesson is still simpler than the list. Do not supervise fresh cement plaster by appearance alone. Supervise the reaction. Protect its moisture, respect its temperature window, and keep each waiting period attached to the exact coat and condition it governs.
I made an audio practice quiz specifically for this episode so you can check whether those decisions are clear. It is audio-based. The questions are read aloud, and you answer by tapping, because I know you may be studying while driving, working, or otherwise on the go. Go to the description below this video. You will see a link that says PassTheCSLB. Tap it. It will take you straight there. If anything in this lesson is still unclear, comment below with your questions and I will use them to help make the material clearer. Subscribe so you can stay on track through every episode until you get your license. I am rooting for you, and I want each drive or work break to move you 1 step closer.
Study with practical, source-backed CSLB B General lessons as I build out the public topic path one audio lesson at a time.
