Framing

Scribing, Plumb, and Level Tolerances

September 11, 2026

Use this for viewing completed on YouTube's website or app.

Test Your Knowledge

3 questions - Audio-based - Study on the go

Mapped to the General B study path

Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.

Related study paths
Source & Confidence

This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.

Official CSLB topicFraming - mapped to the public CSLB B General Building study-guide areas.
California rule verifiedRule, code, permit, safety, minimum, and maximum claims are treated as California-source claims and should be backed by official/public California or CSLB-referenced sources.
Background explanationStories, examples, analogies, and memory aids help busy learners retain the source-backed concepts without sitting in a classroom.
Needs re-checkFor live job, legal, safety, permit, plan, specification, or manufacturer-instruction decisions, verify the current source and follow the AHJ.
Last reviewedSeptember 10, 2026

This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.

The room is allowed to be imperfect. The finished cabinet installation is not allowed to copy that imperfection. That is the central idea I want you to carry through this lesson.

A wall can lean. A floor can slope. Drywall can bow. But a cabinet box still needs to finish plumb, level, true, and straight within the applicable installation tolerance. The installer uses measured adjustment, limited shimming, and accurate scribing to bridge acceptable irregularities. When the substrate is beyond the permitted correction range, the problem goes back to the general contractor for correction. It does not become an unlimited cabinet-installer problem.

That distinction matters because forcing a straight cabinet against a crooked surface does not make the room straight. It can twist the cabinet. Covering the resulting gap does not correct the fit. It only hides evidence of a bad handoff.

Before I apply any numbers, I want the basic words to stay separate in your mind.

Cabinet Fit and Finish Terms Reference. A five-row reference table distinguishing level, plumb, flat, true, and scribe. Columns are Term, Plain Meaning, and Cabinet Field Check.
Cabinet Fit and Finish Terms Reference - A five-row reference table distinguishing level, plumb, flat, true, and scribe. Columns are Term, Plain Meaning, and Cabinet Field Check.

Level describes a true horizontal line or plane. A countertop or cabinet run is checked for level from end to end and from front to back.

Plumb describes a true vertical line or plane. A tall cabinet side or wall may be straight and flat while still leaning away from plumb.

Flat describes the surface itself. A flat wall has no meaningful crowns, bows, or depressions across the area being evaluated. Flat does not automatically mean plumb. Picture a perfectly straight sheet leaning slightly. It is flat, but it is not plumb.

True describes the finished alignment of the work. In casework, I use it as part of the idea that the installation is straight, properly aligned, and not twisted out of shape.

A reveal is the visible spacing around a door or drawer front. Uniform reveals are useful evidence that the cabinet faces and boxes are relating correctly. Uneven reveals can warn me that something is out of alignment, but I do not assume the hinges are the only cause. I check the cabinet box itself.

Scribing is different from all of those. Scribing is the process of transferring the contour of an adjoining wall or ceiling onto an oversized cabinet edge, stile, or filler, then cutting that material to follow the contour. The wall stays imperfect. The finished edge is shaped to meet it cleanly.

If I keep only 1 language rule, it is this. Level is horizontal. Plumb is vertical. Flat concerns bows and dips. Scribing makes the finish edge follow the adjoining surface.

The best time to solve a cabinet fit problem is before the cabinets are unloaded.

For millwork readiness, the Woodwork Institute jobsite guidance in the source report gives separate expectations for walls and floors. Walls receiving millwork are to be plumb and flat within 1/4 in. per 10 ft. Floors are to be level within 1/8 in. per 10 ft.

Those are substrate conditions. They are not the same as the tighter tolerance applied to the installed cabinets.

The North American Architectural Woodwork Standards also identify correction boundaries over a different measuring span. Wall or ceiling variations beyond 1/4 in. in 144 in., and floor variations beyond 1/2 in. in 144 in., require correction before installation and are not the casework installer's responsibility.

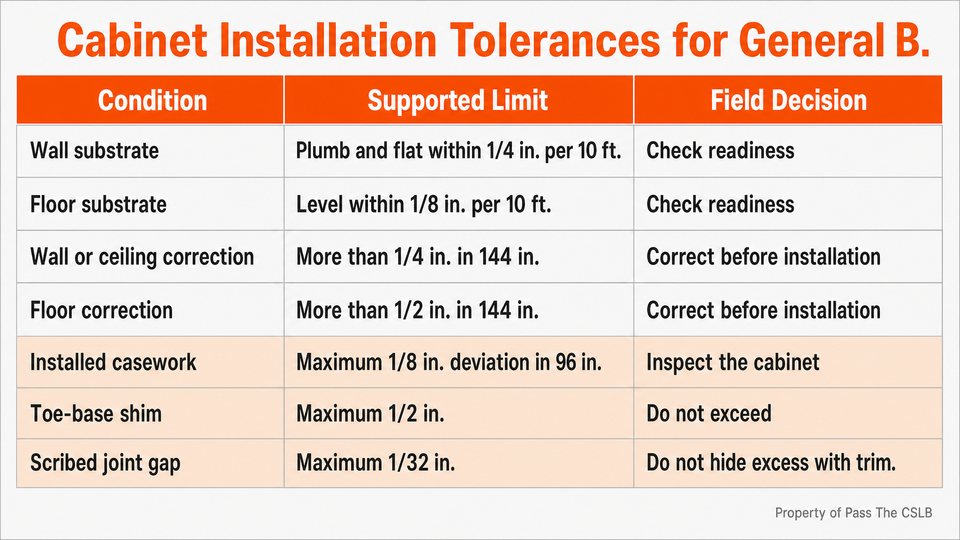

Cabinet Installation Tolerances for General B. A seven-row reference table separating substrate readiness, correction boundaries, finished casework, shimming, and scribing.
Cabinet Installation Tolerances for General B - A seven-row reference table separating substrate readiness, correction boundaries, finished casework, shimming, and scribing.

I put the numbers together in one reference chart because each number belongs to a different condition. The wall substrate line, the floor substrate line, the finished-casework line, the toe-base shim limit, and the scribed-joint limit should never blur into 1 generic cabinet tolerance.

Notice especially that the source uses different spans for different requirements. One statement measures per 10 ft. Another uses 144 in. I do not casually combine them or turn them into a made-up universal rule. I identify the surface, the specified span, and the responsibility attached to that requirement.

For field supervision, the practical move is simple. Check the substrate early. Record the condition. Compare it with the governing plans, specifications, and referenced standard. If it needs structural correction, make that decision before the finish installer is scheduled to make precision work fit a room that is not ready.

The expensive mistake is to treat every irregularity as something a finish carpenter must somehow absorb. Skill can accommodate normal variation. Skill does not erase a substrate defect that falls outside the accepted handoff.

Imagine a contractor who skips the readiness check. The cabinets arrive, the floor problem is finally measured, and the installer cannot proceed within the allowed shimming range. The immediate problem is not just a crooked cabinet. It is a stopped installation, a correction that now competes with finished work, and a schedule that has lost its clean sequence. That consequence comes from the timing of the discovery.

Once the substrate is acceptable, I shift my attention from the room to the cabinet installation itself.

The source-backed installation tolerance is a maximum deviation of 1/8 in. in 96 in. The casework must be installed plumb, level, true, and straight within that limit.

Here is the mechanism worth remembering. A cabinet box is meant to stay square. If the wall behind it bows and an installer simply drives the fasteners until the cabinet back is pulled hard against that bow, the box can twist. That twisting is called racking.

Think about an open cardboard box. Push 1 upper corner sideways and the rectangle begins to become a parallelogram. A cabinet is much more rigid, but the geometric problem is similar. Pulling one area out of plane can disturb the relationship between sides, rails, doors, and drawer hardware.

That is why I do not approve an installation by looking only at whether the cabinet feels tight to the wall. Tight is not the same as true. The installer may need properly located shims behind the casework so the fasteners secure the box without dragging it into the wall's irregular shape.

Racking can show up as doors that do not lie flush, reveals that change width, hinges that bind, or drawer slides that no longer operate in clean parallel alignment. Those symptoms can have more than 1 cause, so I do not diagnose from appearance alone. I verify plumb, level, and true before treating adjustment hardware as the whole solution.

For Custom and Premium grade casework, the cited standards summary also gives reveal-variance limits. Within one unit, the maximum uniform gap variance is 1/16 in. Between separate adjacent units, it is 1/8 in. The important supervision point is that the applicable grade and standard matter. I do not take a tolerance from one specification and silently apply it to every cabinet package.

Shims are legitimate installation tools, but they are not permission to ignore the floor.

The toe base may be shimmed to bring casework level, but the source-backed maximum is 1/2 in. Once the needed correction exceeds that amount, the finish installer has reached the limit of that accommodation.

The deeper issue is support. Cabinetry, countertops, appliances, and stored contents place load through the base into the floor. Controlled shimming can establish level while preserving support. Excessive shimming concentrates support in ways the base was not intended to use and can alter the final relationship among countertops, appliances, and nearby rough-ins.

Suppose a hypothetical 12-foot cabinet run crosses a floor that drops 3/4 in. Asking the installer to stack more shims is not an acceptable way to make the measurement disappear. 3/4 in. is beyond the 1/2-in. toe-base shimming limit, and it is beyond the stated floor-correction boundary over 144 in. The floor or supporting substrate needs correction before casework installation proceeds.

That is the handoff line I want you to recognize. A shim makes a controlled installation adjustment. It does not convert a major floor defect into acceptable finish work.

The general contractor's judgment happens before the cabinet is locked into the problem. Verify the floor, decide who owns the correction, complete that correction, and then release the casework installation. That sequence protects both workmanship and schedule.

At the wall, the same principle appears in a different form. The cabinet stays true, and the finished edge is scribed to the wall.

The source-backed maximum gap at a scribed joint is 1/32 in. That is roughly the thickness of a credit card, which gives the number a useful physical scale. It is a very small finish gap.

Scribing is subtractive. The installer transfers the wall's contour to an oversized edge or filler and carefully removes material until the edge follows that contour. Overlay trim is additive. It places another piece over a gap.

Those are not interchangeable solutions under the cited standard. Additional overlay trim cannot be used to conceal a scribed-joint gap larger than 1/32 in. If the gap is too large, covering it does not turn the underlying scribe into compliant work.

Imagine a filler panel meeting a wall that bows slightly. A straight rip leaves a tapered dark line because the filler does not follow the wall. The correct scribe follows the actual contour while the cabinet box remains plumb. If a separate molding is simply nailed over the tapered gap, the eye may be distracted, but the original fit has not improved.

This is the cleanest memory connection in the lesson. Do not bend the box to match the wall. Keep the box true and fit the scribed edge to the wall.

A scribe also needs to be judged as part of the specified casework quality, not as a decorative afterthought. I look for a controlled, consistent meeting line. I verify that the edge was actually fitted. I do not accept a wide concealed gap merely because a new strip makes the face look busy enough to hide it.

California seismic work adds a sequencing checkpoint, but I need to state its boundary carefully. The requirement I am describing applies where the Woodwork Institute Certified Seismic Installation Program and the related California health-care approval conditions govern the casework. I do not present that project-specific program as a universal detail for every residential kitchen.

California Seismic Cabinet Blocking Sequence. A five-row sequence table for projects governed by the cited Woodwork Institute Certified Seismic Installation Program and related California health-care approval conditions.
California Seismic Cabinet Blocking Sequence - A five-row sequence table for projects governed by the cited Woodwork Institute Certified Seismic Installation Program and related California health-care approval conditions.

Where those requirements apply, the program information calls for continuous in-wall backing for seismic casework anchorage, using the approved wood or metal backing identified by the program. The examples given are 3x6 wood blocking or 16-gauge metal blocking. The backing must be verified and documented before the wall is closed.

That last phrase is the project-management heart of the requirement. Before the wall is closed means before drywall removes visual access to the work. Once wall surfacing covers the framing, the contractor can no longer prove the concealed backing by ordinary observation.

I treat that point as a hard stop in the schedule. Confirm the applicable requirement. Install the specified continuous backing. Verify and document it. Only then release wall closure. The exact approved detail and anchorage still come from the governing program, plans, and project requirements.

Consider a hypothetical project where drywall is installed before the required backing record is complete. Even if someone believes the correct material is hidden inside, belief is not documentation. Access may have to be restored so the concealed work can be verified and corrected if necessary. That means opening finished surfaces, repeating inspection steps, and rebuilding work that could have been checked once in the proper sequence.

The lesson is broader than cabinetry. Whenever one trade conceals another trade's required work, verification belongs before concealment. In this case, the General B contractor controls the handoff between framing, seismic preparation, documentation, drywall, and casework.

I can now reduce the whole inspection to 3 layers: the room, the box, and the joint.

First, the room. I verify that the wall and floor meet the applicable substrate requirements, and I separate a correctable installation variation from a defect that must be fixed before casework begins.

Second, the box. I verify that installed casework is plumb, level, true, and straight within 1/8 in. over 96 in. I check the case itself before assuming that uneven doors or drawers are only hardware adjustments.

Third, the joint. I verify that the edge was scribed to the adjoining surface, that the remaining gap does not exceed 1/32 in., and that overlay trim was not used to disguise a larger gap.

Then I check the 2 limits that protect the handoffs. Toe-base shimming stops at 1/2 in. On projects governed by the cited seismic program, backing verification and documentation happen before wall closure.

Room, box, joint. The room must be ready. The box must stay true. The joint must be fitted. If you can sort each observation into those 3 layers, the numbers become much easier to attach to the correct condition.

Based on the published CSLB study outline, cabinetry and millwork fall under testable Finish Trades material. The useful General B skill is not pretending to replace the cabinet installer. It is knowing when the site is ready, what quality to inspect, where an adjustment ends, and when one trade must stop so another condition can be corrected or verified.
