Wall Blocking and Support for Cabinetry
September 10, 2026
Test Your Knowledge
3 questions - Audio-based - Study on the go
Use the official CSLB B General Building guide as the exam map while you practice this topic with the audio quiz.
This is practical, audio-first exam prep for people studying around real work. Lessons and quizzes are built from official and reputable sources, then shaped into focused review you can use on the go.
This content is produced by Pass The CSLB, an independent audio-first study companion for busy California B General candidates. I build these lessons from official CSLB study-guide topics and reputable source-backed California materials so you can study on the go. This is exam-prep reinforcement, not legal, professional, engineering, or job-specific advice. Exam content is set by PSI and the CSLB and may change, so always verify current requirements against official CSLB materials. No exam outcome is guaranteed. Now let's get into it.
Cabinet support is decided while the wall is still open. Once drywall covers the studs, the most important part of the installation disappears from view. That is the central idea I want you to carry through this lesson. The cabinet may be installed during finish work, but dependable support begins during rough framing.
An upper cabinet does more than hang quietly against a wall. Its own weight pulls downward. Stored dishes and equipment add more downward force. An open door or an extended loaded drawer can also pull outward. The fasteners have to carry those forces through the cabinet and into solid framing. Proper backing gives the fasteners a continuous structural fastening zone and transfers the load into the wall framing. Gypsum board is a finish surface, not a substitute for planned structural backing.
Imagine a contractor who looks at a framed kitchen wall and assumes the cabinet installer can simply find a stud later. The cabinet shop drawings arrive, but nobody compares the mounting elevations with the framing. Drywall is installed, finished, and painted. Then the cabinet crew discovers that the mounting rail falls between the usable framing locations. The contractor now faces a choice between an unsupported shortcut and opening a finished wall. The failure did not begin on cabinet day. It began when rough framing moved forward without the finish information.
That is why I treat cabinet backing as a coordination item, not merely a carpentry item. The General Building contractor has to connect the cabinet drawings, framing work, mechanical, electrical, and plumbing routes, inspection sequence, and wall close-in date. A short review while the studs are visible can prevent a long rework cycle after the wall is finished.

I want to separate structural backing from fireblocking because both can occupy the same wall and still perform completely different jobs. Structural backing supports attached work. Fireblocking cuts off concealed draft openings within framed spaces. Backing deals with load transfer. Fireblocking deals with concealed fire and hot gas movement.
For cabinet support in a typical wood stud wall, the North American Architectural Woodwork Standards identify flat 2x6 blocking as the usual industry detail. That member is placed where the cabinet fasteners need solid wood behind the wall finish. The exact elevation must come from the cabinet information and project details, not from habit.
Fireblocking follows a different set of requirements. California Residential Code Section R302.11 requires fireblocking in concealed stud wall spaces vertically at the floor and ceiling levels and horizontally at intervals not exceeding 10 ft. The code also controls what materials and methods qualify. Ordinary insulation should not be assumed to satisfy a fireblocking requirement merely because it fills the cavity.
A piece of wood might contribute to both functions only when its material, location, and installation satisfy both sets of requirements. I never treat that overlap as automatic. A cabinet backing line placed for a mounting rail may be at the wrong elevation to serve the required fireblocking location. A fireblock may interrupt a concealed draft path but may not give the cabinet installer the continuous fastening zone shown in the woodwork details.

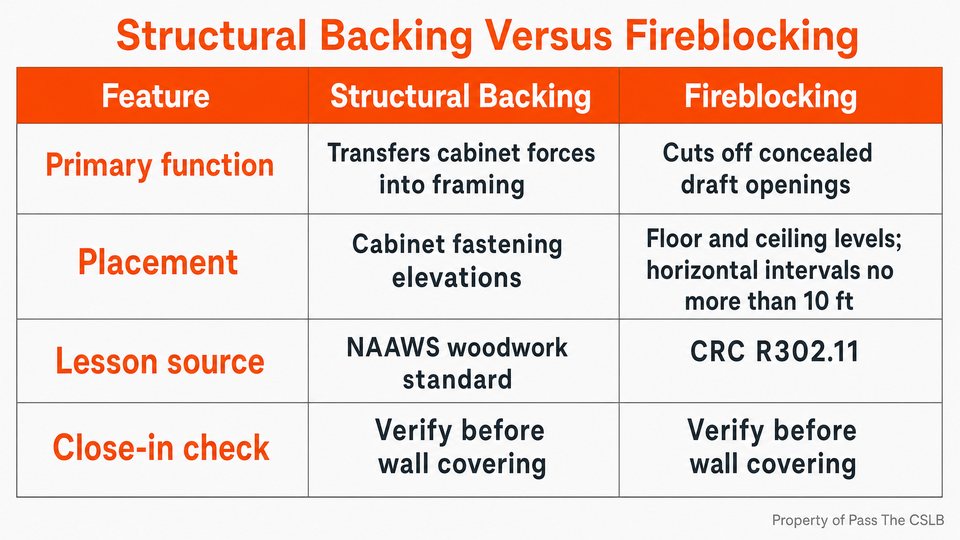

The clean memory connection is simple. Backing carries the cabinet. Fireblocking interrupts the concealed opening. Similar material does not mean identical purpose.
The best time to coordinate backing is when the cabinet layout is settled enough to locate the work but the walls are still open enough to make changes. I start with the approved project information: architectural plans, cabinet shop drawings, elevations, sections, appliance requirements, and the manufacturer's installation instructions. I also confirm which document governs if those sources disagree instead of letting the framing crew guess.
Finished floor elevation matters. A blocking height measured from the slab or subfloor can be wrong after flooring, underlayment, or other finish buildup is added. I want the cabinet mounting zone tied to the finished condition shown on the drawings. That is especially important where an accessible counter, a tall appliance opening, or a special mounting rail fixes the final elevation.
The phrase by others deserves attention. In the architectural woodwork standards, in-wall structural members, blocking, backing, and related support are generally furnished and installed by others rather than by the cabinet manufacturer or finish installer. On a General Building project, that means I cannot wait for the cabinet installer to arrive and discover what the rough framing crew omitted. Contract language can assign work differently, but the support still has to be coordinated and installed before concealment.
For a typical wood stud condition covered by the woodwork standard, flat 2x6 backing creates the fastening zone. I verify the correct wall, the correct elevation, the required run, and any interruption caused by plumbing, wiring, ducts, or openings. I also check that a late trade penetration has not removed or weakened the support after it was installed.
The same thinking applies to an island, but the support path changes because there may be no full-height wall behind the cabinets. Island anchorage can involve the subfloor, a framed pony wall, or another project-specific detail. Plumbing and electrical routes may compete for the same limited space. I follow the approved plans, cabinet requirements, and any engineered or manufacturer detail instead of inventing a universal island detail.
Before close-in, I like a simple record of what will soon become invisible. Clear photographs with a reliable location reference can help the installer and can document coordination. Photographs do not replace an inspection, approved plans, or required installation details. They preserve information that would otherwise be hidden behind a smooth wall.

The rough inspection sequence protects that last clear view of the wall assembly. Under California Residential Code Section R109.1.4, the frame inspection occurs after the roof, framing, fireblocking, and bracing are in place and after the rough plumbing, mechanical, and electrical inspections are approved. Drywall comes after the required rough approvals, not before them.
The practical reason is visible on almost every project. Mechanical, electrical, and plumbing work can require holes, notches, or routes through framing spaces. If a trade modifies a stud, plate, cabinet backing member, or fireblocking condition, the final rough condition is different from the condition that existed before that work. The frame inspection needs to address the condition that will actually be concealed.
Suppose an electrician finds that a planned cable route crosses the cabinet backing. Moving the cable may solve the conflict. A permitted penetration or a revised backing detail may solve it. Cutting away the backing and saying the cabinet crew will figure it out later does not solve it. I coordinate the affected trades, follow the approved requirements, and make sure the completed condition is available for inspection before the wall is covered.
If work changes after an approval, I do not assume the earlier approval automatically covers the new condition. The local building official determines required inspections and any needed reinspection. That authority matters because project conditions, approved documents, and local administration can affect the next step.
Now return to the hypothetical finished kitchen wall. If the installer finds missing backing after drywall, the sound response is not to multiply drywall anchors until the cabinet feels firm. The response is to stop, verify the required support, and provide a compliant attachment path. That may mean opening the wall, installing the required backing, obtaining any needed inspection, and restoring the finish. It is frustrating, but concealment never converts missing support into adequate support.
The same principle applies before the first sheet is hung. I verify structural backing and fireblocking as separate items. I confirm that rough trade work is complete and approved. I make sure any framing damage or conflict has been resolved. Only then is close-in a controlled handoff instead of a gamble.

The woodwork standard also provides a fastening pattern for cabinet anchorage. The source material for this lesson identifies sheet metal screws spaced 16 in. on center and positioned 2 in. from each cabinet corner. Those numbers are useful study references, but they do not authorize a single fastener choice for every cabinet, substrate, or project.
Fastener type, diameter, length, head style, and required penetration have to match the governing standard, approved details, manufacturer instructions, and actual backing condition. A screw that reaches wood is not automatically adequate. The attachment has to transfer the expected load through the cabinet or mounting hardware into the structural backing without relying on gypsum board as the primary support.
Seismic work also requires careful boundaries. For wood stud walls in regulated California facilities using the Woodwork Institute Certified Seismic Installation Program, the source material identifies continuous 3x6 in-wall blocking. That is not a blanket rule for every kitchen in California. It is a program-specific requirement for covered work. I first identify whether the project is subject to that program, an approved seismic detail, health care review, engineered requirements, or another governing specification.
This is where a General Building contractor needs disciplined escalation. Routine coordination belongs in normal supervision. Exact load design, unusual casework, special seismic anchorage, or a conflict among approved documents may require the cabinet manufacturer, design professional, engineer, or authority having jurisdiction. Guessing is not coordination.
Accessibility turns cabinet backing into an elevation-control issue. For covered accessible facilities, the source material identifies a maximum height of 34 in. above the finished floor for an accessible transaction or work counter, with an accessible segment at least 36 in. long. The approved plans and California Building Code Chapter 11B determine where that requirement applies.
The words above the finished floor are doing important work. Cabinet box height, countertop thickness, supports, shims, and floor finish all contribute to the final elevation. If the rough crew measures from an unfinished surface without accounting for the specified finish buildup, the completed counter can miss the required height even though the tape measurement looked correct during framing.
Imagine standard casework that would create a 36 in. finished counter where the approved accessible detail requires no more than 34 in. Raising or lowering only the backing may not fix the cabinet geometry. The cabinet selection, support, countertop, clearances, and backing elevation have to agree before fabrication and installation move too far forward.
I do not use a remembered federal number as a substitute for the California project requirements. I check the applicable California accessibility provisions, approved plans, and project details. This prevents a rough framing assumption from becoming a finish-stage accessibility correction.
My field verification is straightforward. I identify who is responsible for furnishing and installing the backing. I compare the cabinet elevations with the finished floor datum. I verify the backing size required by the applicable standard or project detail. I check the mounting run and any openings or trade conflicts. I inspect fireblocking separately. I confirm the required rough approvals before close-in. Then I preserve useful concealed-condition records for the cabinet handoff.
I also communicate changes. If the cabinet package is revised, the earlier backing layout may no longer work. If an appliance changes, a utility route can move. If a wall shifts, the cabinet run and accessible segment can shift with it. A field mark based on an old drawing is not protected merely because it was installed first.
The cabinet installer should receive a wall that matches the coordinated information. The installer still has to follow the required fastening and installation details, but the installer should not be asked to create structural framing through finished drywall. That boundary is the practical meaning of planning support before close-in.

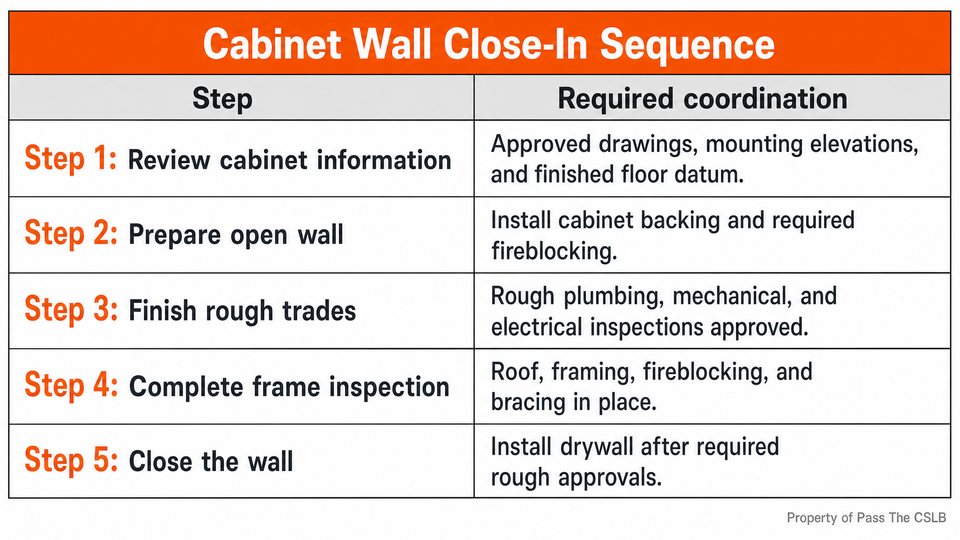

Here is the counterfactual I want you to remember. What happens if the wall is covered before backing, fireblocking, rough trade conflicts, and inspection status are verified? Visibility disappears, uncertainty rises, and correction becomes more destructive. The wall finish adds no strength to a missing load path and no proof to an uninspected concealed condition.
The shortest useful memory line is this: support first, cover last. Backing transfers cabinet forces into framing. Fireblocking addresses concealed draft openings. The rough mechanical, electrical, and plumbing approvals come before the frame inspection, and required rough approvals come before drywall. Standard backing, seismic anchorage, fastener layout, and accessible heights must each be tied to the governing project requirements.
Official preparation resources identify cabinetry and millwork, project coordination, and field inspection performance as key areas. The skill is not memorizing isolated numbers without context. It is recognizing when a finish installation depends on an invisible rough-stage decision and making that decision while it can still be inspected and corrected.
I made an audio practice quiz specifically for this episode's material. The questions are read aloud, and you answer by tapping, so it works for people studying while driving, working, or otherwise on the go. Go to the description below this video. You will see a link that says PassTheCSLB. Tap it. It will take you straight there. Comment below with any questions about wall blocking, fireblocking, inspection sequence, fastening, or accessibility. Subscribe so I can help you stay on track through every episode until you get your license.
Study with practical, source-backed CSLB B General lessons as I build out the public topic path one audio lesson at a time.
